The Redmen TV 15th Anniversary Campaign

Executive Summary

This campaign plan aims to enhance The Redmen TV marketing performance. To begin with, it visualizes the company using the BMC and 7 Assets to introduce it. Then, by utilizing VRIO and 4Cs framework analysis and secondary data, the plan points out that although the brand has competitive advantages, it has obvious shortcomings such as in brand exposure and user interaction. Finally, it applies the RACE framework to propose a comprehensive digital strategy, supported by a cost-benefit analysis and implementation plans.

1. IntroductionView details

1.1 Overview and Business Model Canvas of The Redmen TV

The Redmen TV is an independent digital media platform that exclusively focuses on covering LFC. It provides football fans with in-depth match analysis, tactical breakdowns, exclusive interviews, and fan reactions (Net Worth Spot, 2025).

The Redmen TV was established in June 2010. Over time, it expanded into a subscription-based model, offering premium content on platforms such as Redmen PLUS and YouTube Memberships. The company primarily relies on ad revenue, sponsorships, paid memberships for monetization (Net Worth Spot, 2025), events, merchandise etc. According to The Redmen TV’s LinkedIn profile, the company is private and is currently hiring 16 individuals (LinkedIn, no date).

Using the BMC helps identify key activities and channels where marketing efforts can be strengthened (Osterwalder and Pigneur, 2013). Fig. 1 shows the BMC of The Redmen TV.

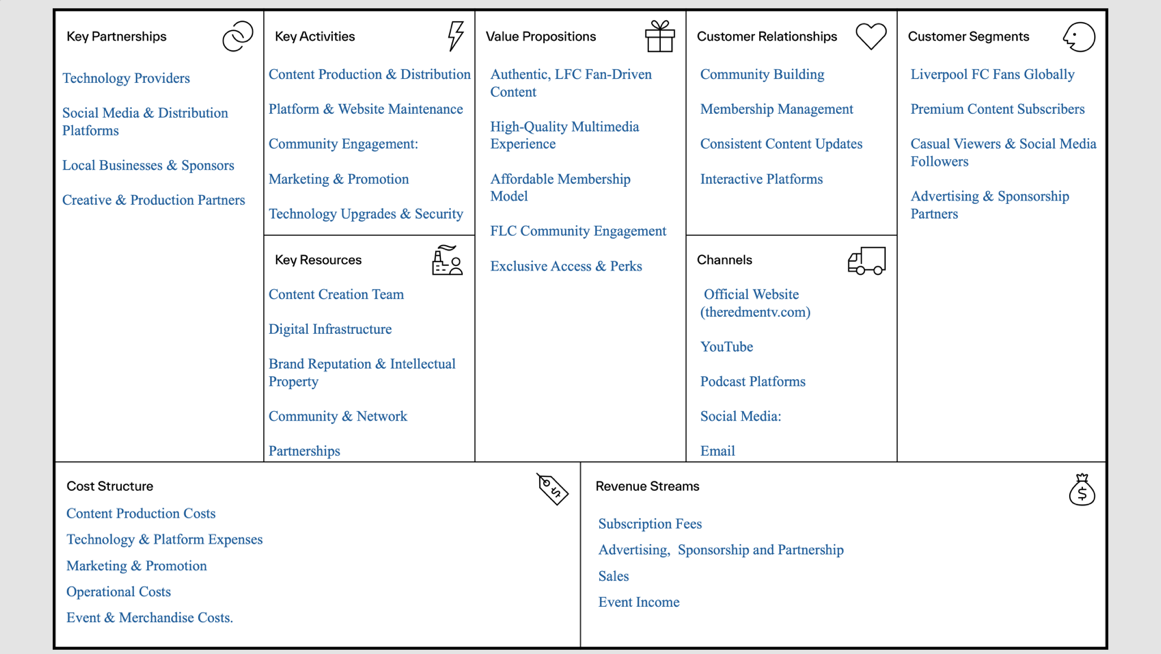

The Redmen TV report figure
Fig. 1. BMC of The Redmen TV
Source: Adapted from https://www.strategyzer.com/library/the-business-model-canvas

1.2 Seven Assets of The Redmen TV

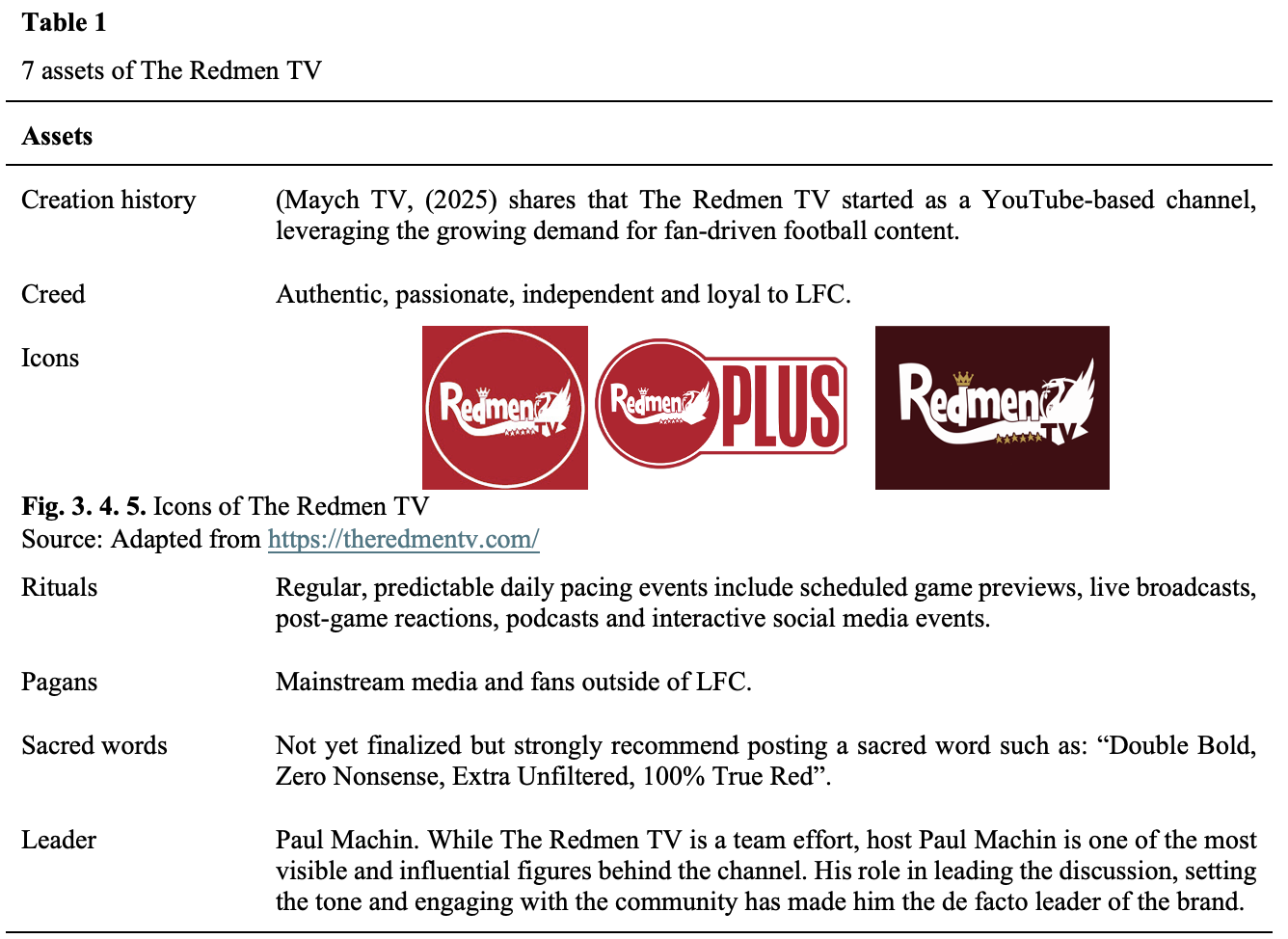

Table 1 illustrates the 7 assets of The Redmen TV, note how rituals like regular matchday content routines and creed can be used in messaging to strengthen brand loyalty or how identifying pagans clarifies who is outside the target audience. By doing so, the paper will demonstrate a nuanced application of brand community theory (Hanlon, 2006) in enhancing fan engagement.
Table 1 illustrates the 7 assets of The Redmen TV, note how rituals like regular matchday content routines and creed can be used in messaging to strengthen brand loyalty or how identifying pagans clarifies who is outside the target audience. By doing so, the paper will demonstrate a nuanced application of brand community theory (Hanlon, 2006) in enhancing fan engagement.

1.3 Current Marketing Priorities of The Redmen TV

According to Maych TV (2025) and the interview between the guest speaker and Xihao Zhang, the marketing position is closely related to fans’ needs and strives to communicate football culture genuinely and engagingly. The company’s marketing focuses on creating a cross-platform communication matrix through YouTube and social platforms, attracting users with free content like short videos, podcasts, and online interactions. Balancing business and content quality under the “passion and creativity first” concept, the company aims to build a loyal and profitable media brand.

2. Marketing ChallengesView details

2.1 Audience Growth and User Engagement

The Redmen TV's current audience growth is slowing. The channel has exceeded 500,000 subscribers around 2020 (The Redmen TV, 2022). In the following years, it only grew to about 557,000 according to data from VIDIQ (Data updated on Feb 18, 2025), a relatively slow growth rate. This suggests that saturation is approaching among core Liverpool fans, making it difficult to reach new audiences further.

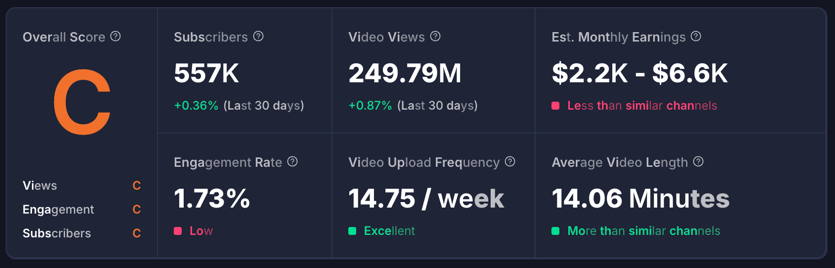

Fig. 5. The Redmen TV’s YouTube Stats - VIDIQ
Fig. 5. The Redmen TV’s YouTube Stats - VIDIQ

Source: https://vidiq.com/youtube-stats/channel/UC30avO2n6knAFiH2c8e4qiw/

From a perspective of consumer, Lauterborn’s 4Cs analysis is used to compare The Redmen TV with a direct competitor (This Is Anfield) and an indirect competitor (Tifo Football), highlighting differentiation issues. The number of their YouTube fans is shown in Fig. 6.

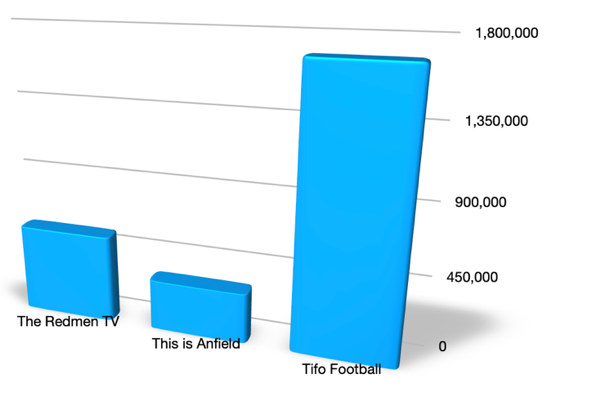

Fig. 6. The YouTube subscriber base of The Redmen TV and its competitors
Fig. 6. The YouTube subscriber base of The Redmen TV and its competitors

Source: Tidy up from https://www.youtube.com/@theredmentv, https://www.youtube.com/@thisisanfield, https://www.youtube.com/@Tifo

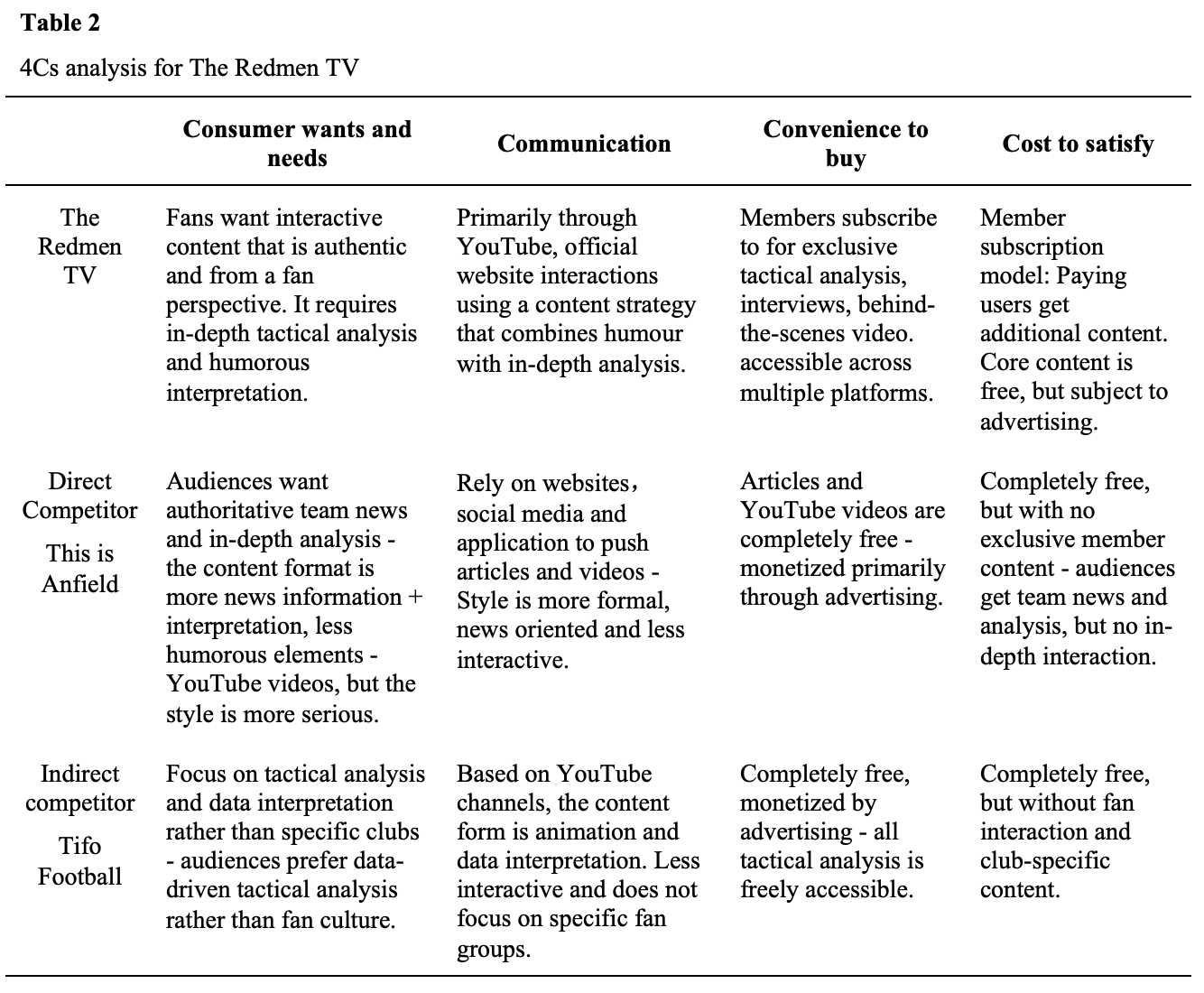

Table 2 comparison shows that The Redmen TV is unique in asking viewers to pay for some content, which raises the value proposition barrier by requiring the exclusive content to be compelling enough to justify subscription costs.
Table 2 comparison shows that The Redmen TV is unique in asking viewers to pay for some content, which raises the value proposition barrier by requiring the exclusive content to be compelling enough to justify subscription costs.

Another piece of evidence from the Similarweb report is the low engagement rate and short visit duration.

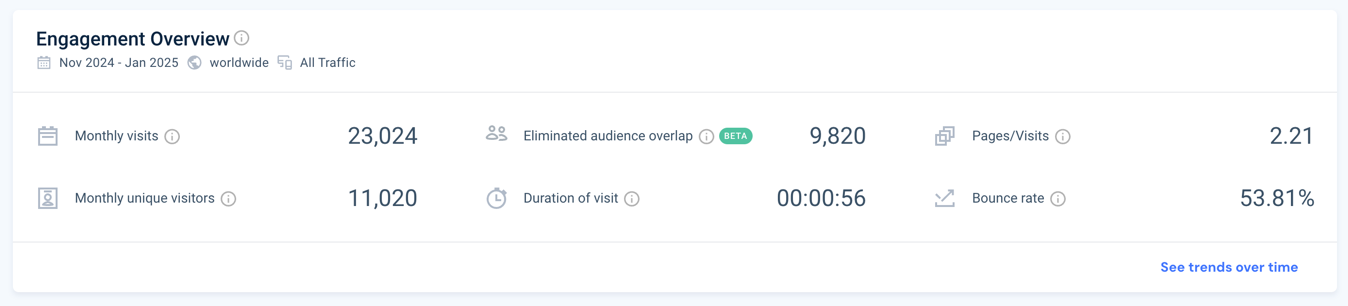

Fig. 7. Similarweb analytics for The Redmen TV’s official website
Fig. 7. Similarweb analytics for The Redmen TV’s official website

In addition, in terms of user engagement, although the core fans are still active (paying members subscribe to "Redmen TV Plus", purchase peripheral products, etc.), how to retain the universal fans and turn them into loyal users is a challenge.

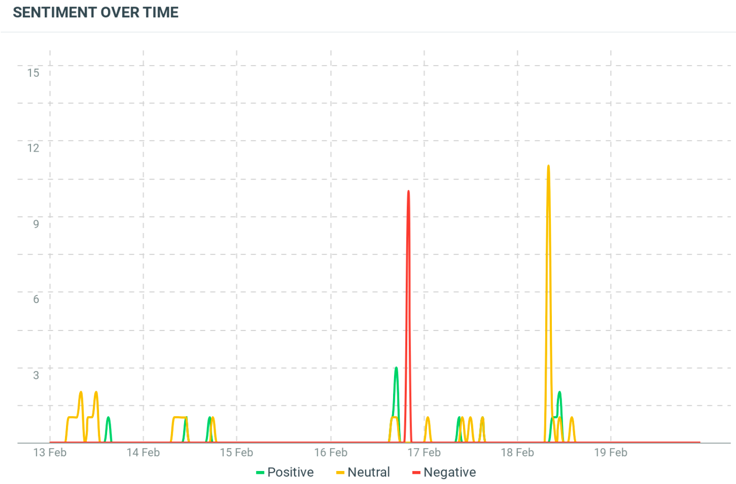

The Redmen TV report table visualThe Redmen TV report table visual

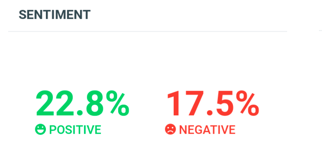

Fig. 8. Hootsuite listening report for The Redmen TV

According to Hootsuite's monitoring report data, negative sentiment is 17.5 percent. This may have affected the trust and stickiness of some viewers to the channel to some extent.

In general, how to continuously attract new fans, activate existing fans, and control negative public opinion is the main problem Redmen TV faces in terms of audience growth and user retention.

2.2 Competitive Analysis

From a consumer demand perspective, target audiences expect more diverse and interactive content (Euromonitor International, 2025), while existing content formats and payment models fail to convey high value propositions, resulting in a mismatch between user perceptions and actual payment expectations.

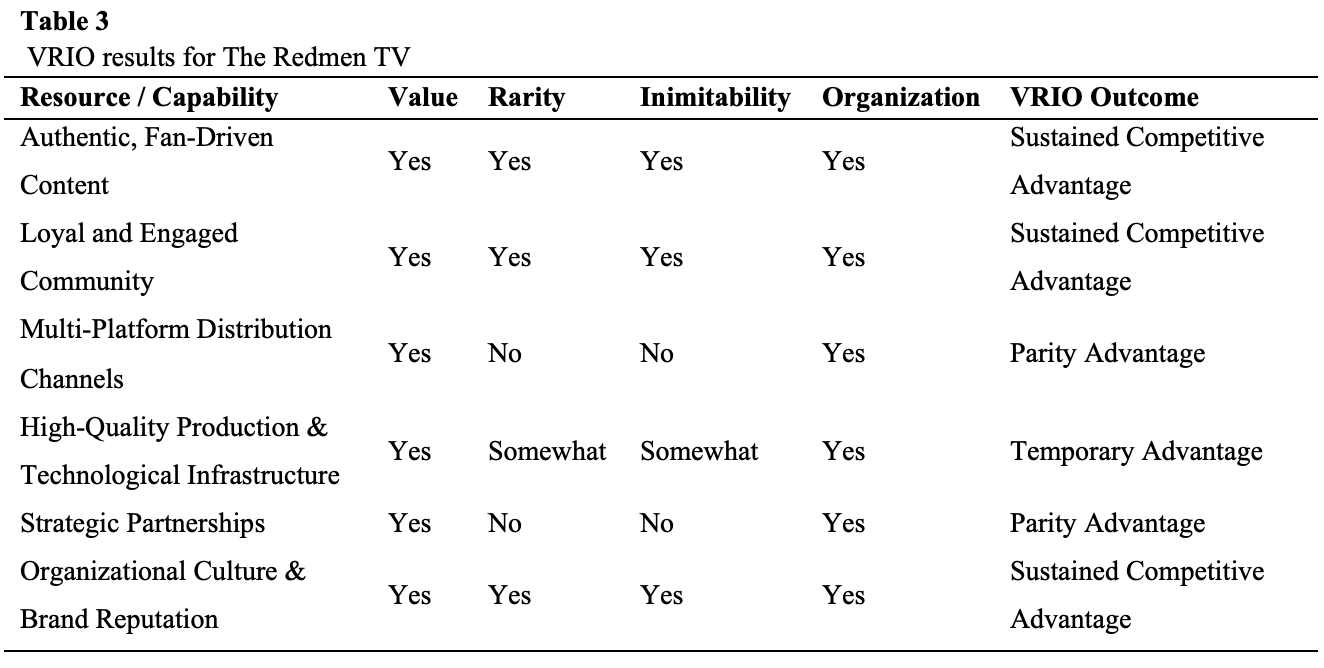

The Redmen TV report figure

By utilizing (Barney and Hesterly, 2019)’s VRIO framework, Table 3 highlights The Redmen TV’s strongest competitive advantages: authentic content, community participation, and a strong brand culture. These unique resources, though valuable and scarce, are difficult for competitors to emulate and are well supported by the organization. While distribution channels and production infrastructure provide valuable support, they are not as unique. Focusing on its strengths and optimizing other areas will allow The Redmen TV to maintain and grow its competitive position.

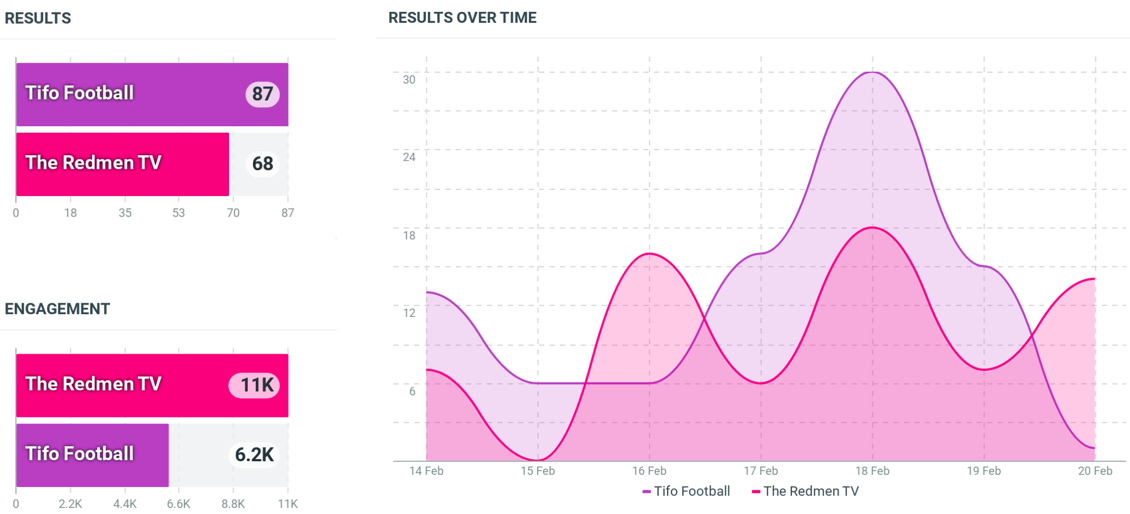

Fig. 9. Hootsuite listening report for The Redmen TV, and Tifo Football
Fig. 9. Hootsuite listening report for The Redmen TV, and Tifo Football

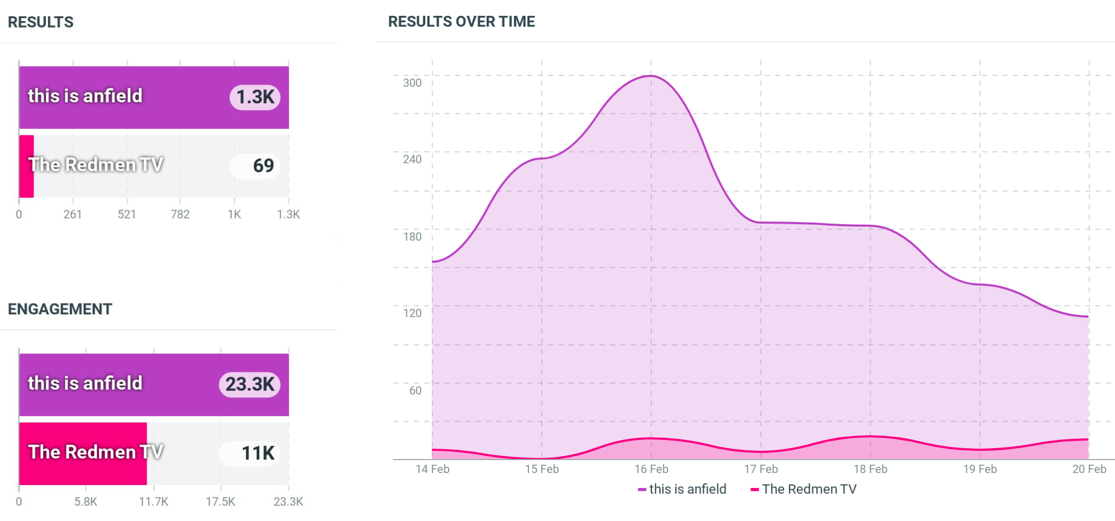

Fig. 10. Hootsuite listening report for The Redmen TV, and this is Anfield
Fig. 10. Hootsuite listening report for The Redmen TV, and this is Anfield

The results showed that while some of The Redmen TV's content received a certain number of views, the overall engagement rate was significantly lower than its competitors. This suggests that the current promotion strategy is not effective in engaging users and driving users from a single channel to other platforms.

Therefore, the current competitive position of Redmen TV in the industry is: leading in Liverpool fan media, but in the middle of the whole football we-media landscape, it needs to consolidate its characteristics and continue to innovate in order to cope with the surrounding competition.

2.3 Branding and Awareness

As The unofficial fan media of LFC, The Redmen TV has accumulated a certain brand foundation and audience scale. It is well known among Liverpool fans, YouTube channel has approximately 558,000 subscribers, about 680,000 Twitter followers and about 420,000 Facebook followers (Feedspot, 2025).

Fig. 11. The fans of The Redmen across platforms
Fig. 11. The fans of The Redmen across platforms

Source: Adapted from Feedspot https://videos.feedspot.com/liverpool_fc_youtube_channels/

Its fans come from all over the world, and the traffic of their official website are mainly from The United Kingdom (58.55%), The United State (14.40%), Ireland (9.07%), Netherland (5.22%), Australia (2.97%), Indian (2.32%), Canada (2.02%), Germany (1.64%), Malaysia (0.73%), Romania (0.54%), etc.

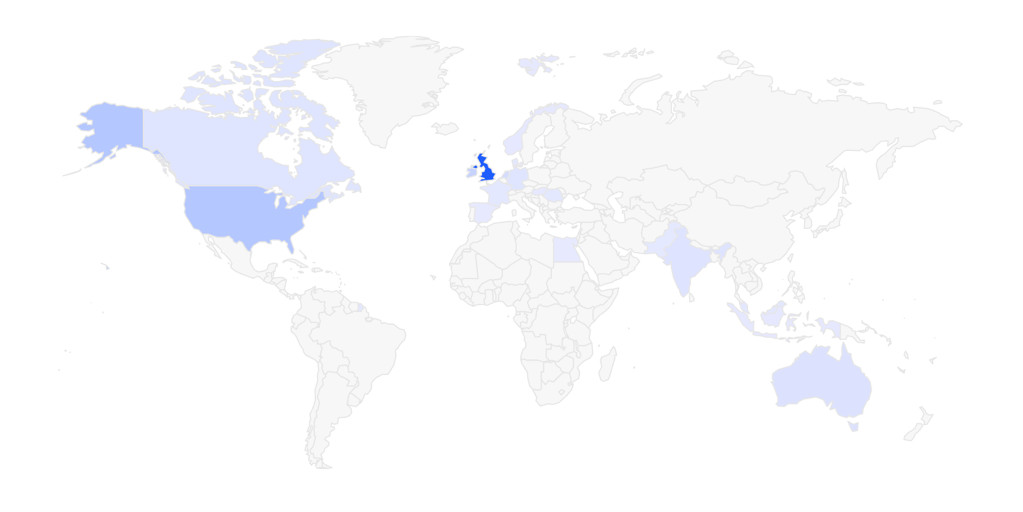

Fig. 12. The fans demographics of The Redmen TV
Fig. 12. The fans demographics of The Redmen TV

Source: Similarweb analytics for The Redmen TV’s official website

However, compared with the top football media, brand expansion still has bottlenecks. The ranking of The Redmen TV as shown as Figure 13:

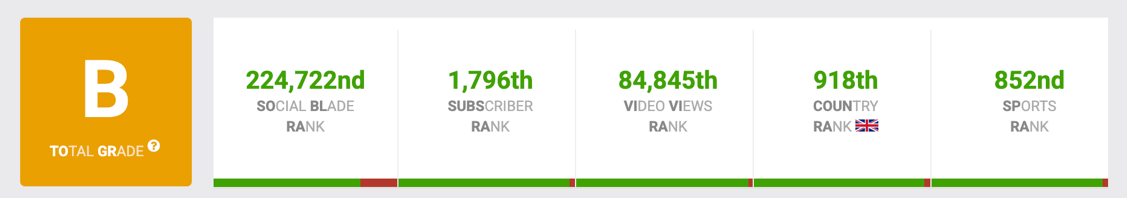

Fig. 13. The Redmen TV’s YouTube Stats – Social Blade
Fig. 13. The Redmen TV’s YouTube Stats – Social Blade

Source: https://socialblade.com/youtube/c/theredmentv

At present, the audience is mainly concentrated in the Liverpool fans and has not yet broken through the circle. The Redmen TV team is also aware of this, having publicly stated that they "want to reach more Reds fans around the world" and strengthen brand awareness. They are even hiring marketing assistants in 2022, dedicated to enhancing brand exposure and business promotion (Hoare, 2022), which shows that expanding brand impact is an urgent need for them.

The Redmen TV 15th Anniversary Campaign

To capitalize on the important milestone of The Redmen TV's 15th anniversary. This section will focus on audience growth and user engagement. According to the RACE (Chaffey, 2024) framework and entrepreneurial marketing principles, a feasible and comprehensive social media campaign was designed to enhance brand exposure and stimulate user engagement through multi-platform interactions.

3.1 Reach – Cross-platform Hash Sign Campaign.

Create a high-quality 15th anniversary video that looks back at the growth of The Redmen TV, showcasing the most memorable moments, classic content and fan stories. This plan designed a event poster which present in Figure 14:

Fig. 14. Reach plan
Fig. 14. Reach plan

Start the #REDMEN15 hashtag campaign on Instagram, TikTok, X(Twitter) and Facebook. Fans are encouraged to share their stories, memories, or favourite moments with The Redmen TV. Add local exposure with geolocation tags. The most popular content creators on each platform will receive a one-year Redmen TV Plus membership. The implementation method and expected outcomes are as Table 4:

The Redmen TV report figure

3.2 Act - Video Comment Interactive Rewards Program

Create a high-quality 15th anniversary video that looks back at the growth of The Redmen TV, showcasing the most memorable moments, classic content and fan stories, the top three comments with the most likes will be rewarded with 1-year, 6-month, and 1-quarter membership respectively. This plan be visual presented in Fig. 15:

Fig. 15. Act plan
Fig. 15. Act plan

The campaign lasts for two weeks, and fans are regularly reminded to participate on social platforms. The implementation method and estimated outcomes are as follows:

The Redmen TV report figure

This strategy should involve continuously monitoring comment and engagement sentiment to gauge the resonance of content. Utilizing tools such as Hootsuite listening can help achieve this. By incorporating a feedback loop, analytics become more dynamic and user centric.

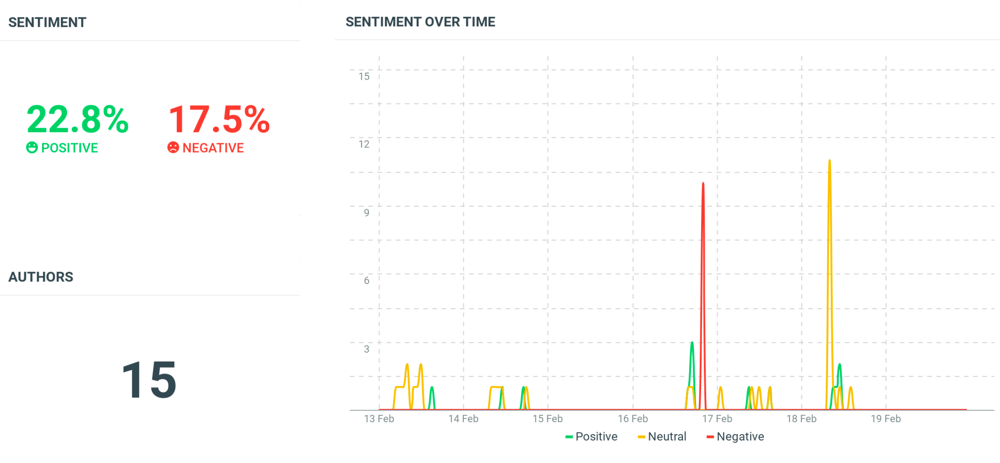

Fig. 16. Hootsuite listening report for The Redmen TV
Fig. 16. Hootsuite listening report for The Redmen TV

These strategies are aligned with relevant consumer trends. Audiences crave participation in online communities and a sense of belonging, and they are more willing to engage in immersive, interactive experiences (Euromonitor International, 2025). Using humour, trending topics, and interactive content can further enhance engagement (Hootsuite Inc., no date).

3.3 Convert – Lucky Subscriber

To satisfy the audience preference for sustainable, meaningful brand interactions and their desire for exclusive rewards (Euromonitor International, 2025). Low budget guerrilla marketing tactics or responding to fan feedback is important (Kotler et al., 2025), this plan suggests plan convert strategy: For each video posted over the next three months, five random reviewers will receive a limited edition The Redmen TV 15th Anniversary Edition hoodie. The hoodie design incorporates elements of the 15th anniversary logo and Liverpool FC and is only available through this event. Participation requirements: Must subscribe to YouTube channel; Comment on the video. The lucy subscriber cannot be reward more than one time. The advertise picture with the prospective results are presented in Fig. 17 and Table 6:

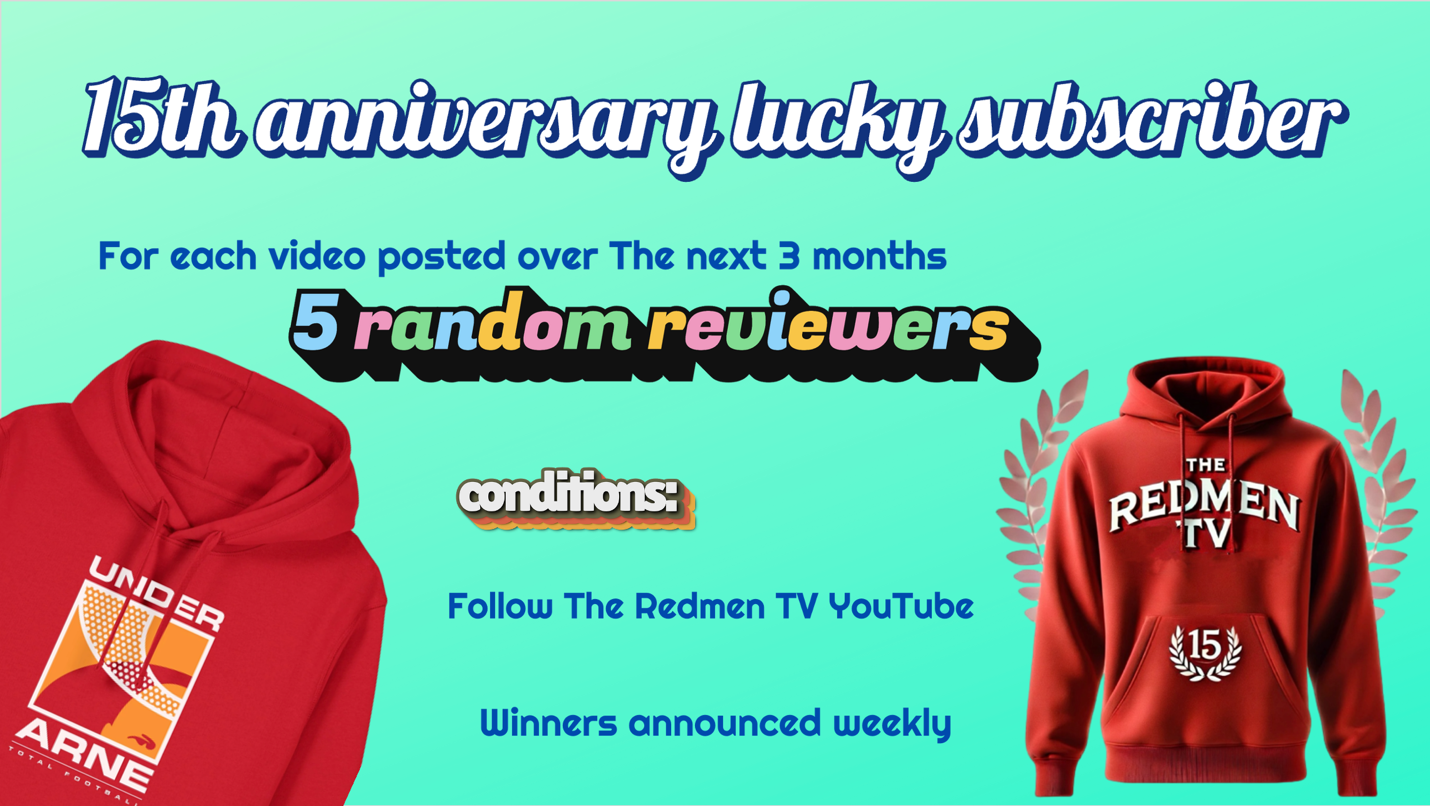

Fig. 17. Convert plan
Fig. 17. Convert plan
The Redmen TV report figure

3.4 Engage – Top-up Discount

Mintel (2025) reported that audiences are willing to pay for cost-effective content but are sensitive to value. However, loyal audiences are willing to pay for brand-exclusive experiences (Euromonitor International, 2025). Combining these insights with The Redmen TV’s current situation, the engage strategy focuses on repeat purchases, satisfaction, loyalty and advocacy through an anniversary top-up discount. The campaign enhances users' willingness to pay and brand stickiness through limited-time offers. It offers a 15% discount on Redmen TV Plus membership during the anniversary period (recommended 1 month) to encourage new subscribers to try and renew their subscriptions. Promo codes such as “REDMEN15OFF” can be posted across social media and official websites for easier campaign tracking. The discount can also link with the hashtag activity to form an integrated marketing voice. Countdown reminders at the end of YouTube videos, in community posts, and on social platforms can create urgency and guide more users to act.

Fig. 18. Convert plan
Fig. 18. Convert plan
The Redmen TV report figure

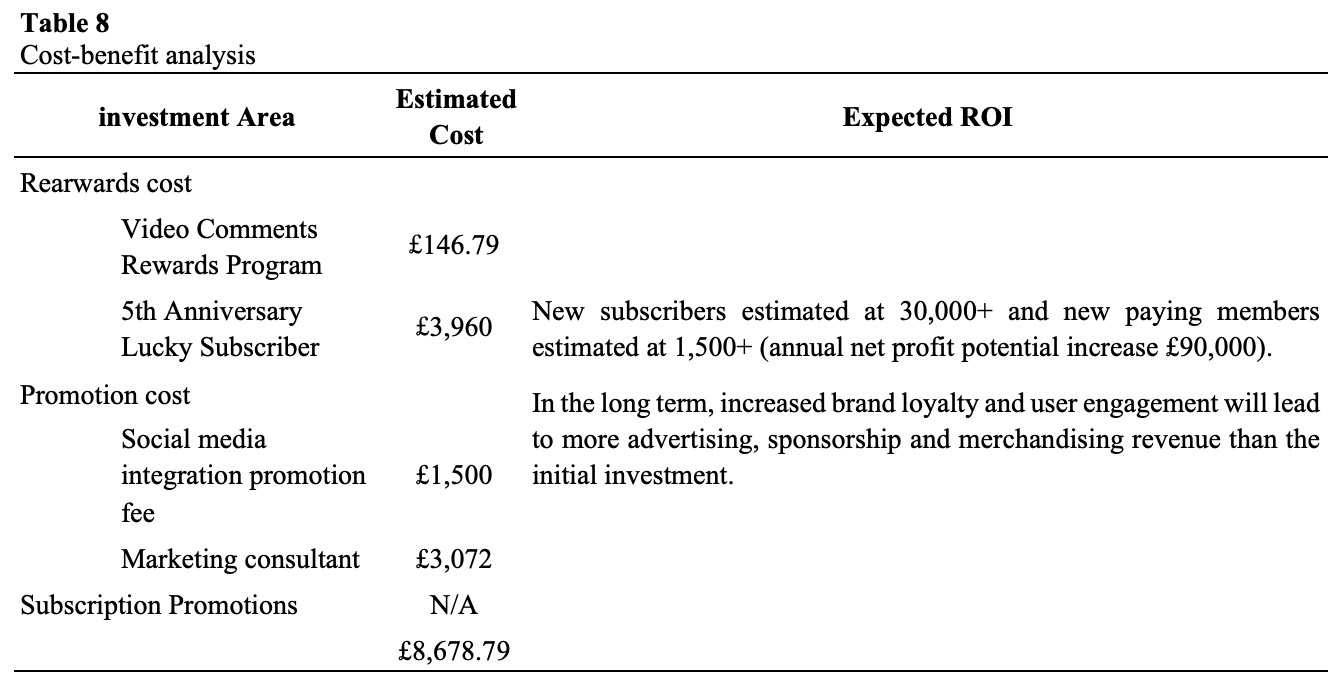

3.5 Cost-Benefit Analysis

The Redmen TV report figure

Assumptions: The cost of reward membership is based on the price of caption membership which is £6.99 and the £20.00 per hoodie.

The top-up discount does not generate a direct cash outlay but has an opportunity cost - the discounted price converts member revenue below the normal selling price.

3.6 Implementation Timeline

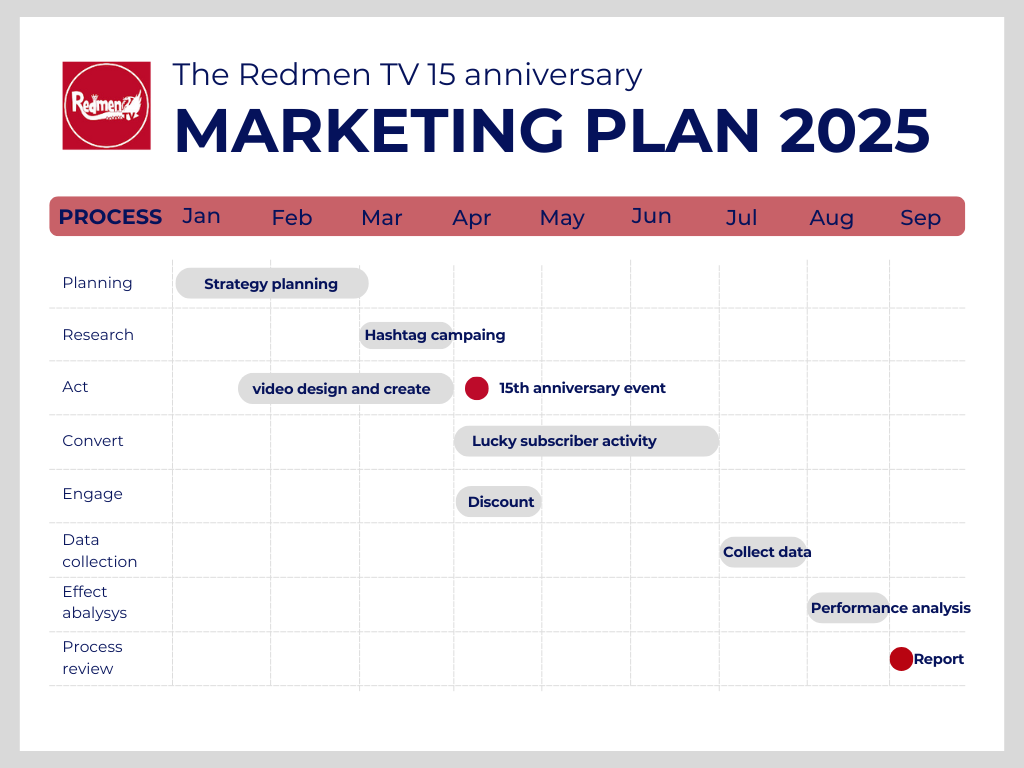

Fig. 19. 15 anniversary plan Gantt chart
Fig. 19. 15 anniversary plan Gantt chart

3.7 Plan Limitation

The success of hashtag, videos will depend on algorithmic exposure; we will monitor the results closely and adjust the content style if necessary. This solution may be easy imitated by competitors. Thus, it needs to develop a first-mover advantage.
